PHASE I
Date | Activity |
October 2007 | Commenced Field Investigations |
January 2008 | Commenced Preparatory Works |
December 2008 | River Diversion Completed |
PHASE II
Date | Activity |
January – November 2009 | Riverbed excavation & foundation works |

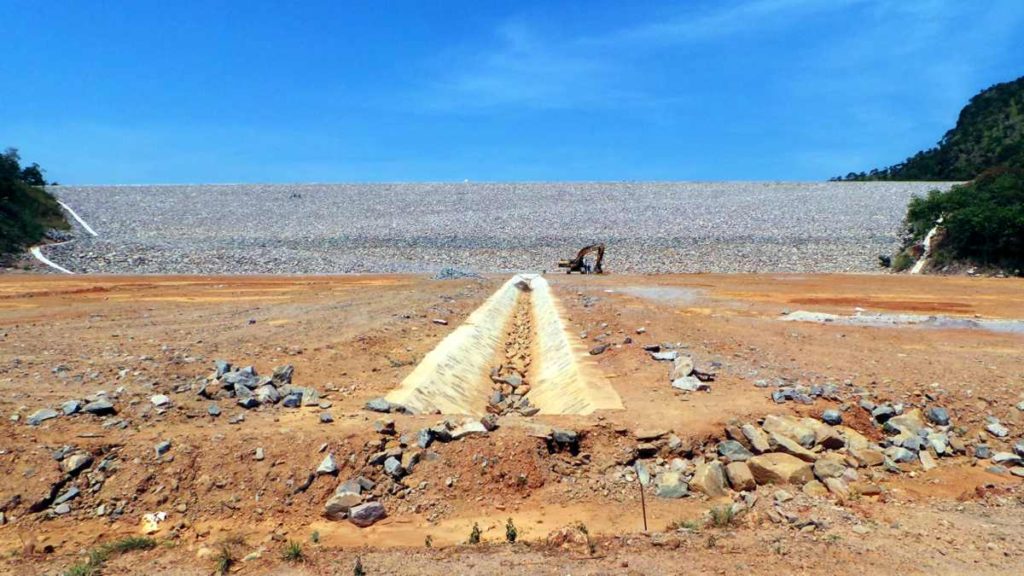

December 2009 | Commenced Main RCC Dam |
June 2011 | Commencement of Reservoir Filling |
May 2013 | Commissioned First Unit |
July 2013 | Commissioned Second Unit |
December 2013 | Completion and Commissioning of Bui Generating Station |
